October 29, 2021 Master Facility, Update #5

October 29, 2021 Master Facility Update #5

Below is an overview of construction that is happening at Cheyenne Regional West for this upcoming week.

Highlights:

  1. Rooms on 3-2 will be closed on Monday, November 1, to accommodate new plumbing lines above on the 4th floor.
  2. Roofer will be utilizing a fork lift and need to close 24th Street near Evans Ave. on Tuesday, November 2nd. Access to cancer center and dock will route off of Warren.
  3. New framing noises and continuing demolition noise on the 4th floor due to work on Master Facility Plan

#1



What is happening?

Portion of 3rd floor will be blocked for construction – the contractors are installing new drain lines for 4th floor patient rooms and need to access the bottom of the floor (ceiling of 3rd floor) to set the piping. This will be performed in 4 phases.



Where is this happening?

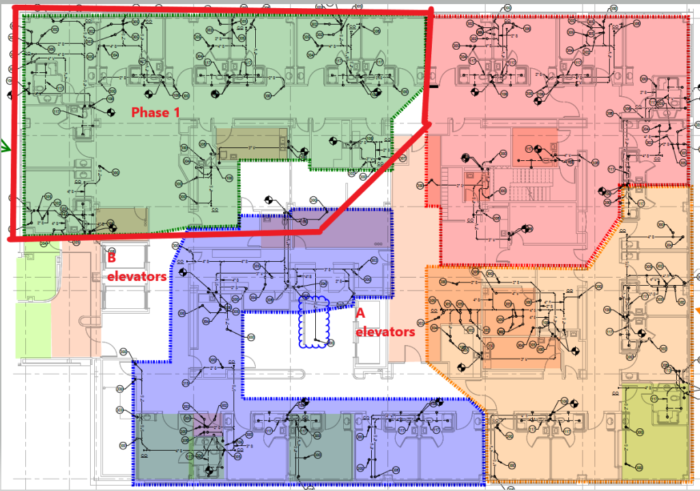

3-2 Surgical Ortho Neuro Unit (SONU) – Phase 1 in green

  • Rooms 3218 – 3225
  • Dirty Room
  • EVS Closet
  • Nutrition Room
  • Portion of the clean room north entrance



When is this happening?

Monday, Nov 1 – for about 4 weeks



Why is this happening?

Master Facility Plan – Plumbing work in the ceiling on 3-2 to tie in areas on the 4th floor

Who to call with questions?

Peg Jolovich, extension 2672

Jackie Van Cleave, extension 7785

Phil Villarreal, extension 7979

Kelly Archer, extension 6487



2



What is happening?

West Building –  24th Street Road Closure to accommodate Fork Lift to lift Materials for Roof Replacements

Access to dock, North Parking Garage, and Cancer Center will be available from Warren.

When is this happening?

November 2 (Tuesday)

Why is this happening?

We are performing roofing repairs and replacements on several roofs at the West Campus.

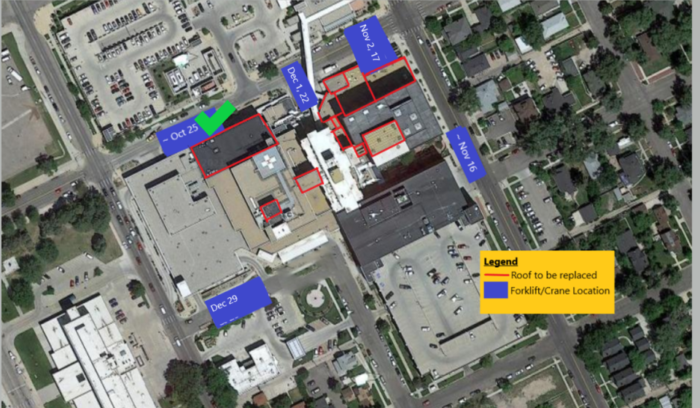

This map shows you approximate dates and locations of future lifts that are needed for this project.  The green circle represents the latest area to have a closure.

Who to call with

questions?

Phil Villarreal, extension 2297

Candis Pickard, extension 7890

Kelly Archer, extension 6487



#3



What is happening?

Framing is going to begin on the 4th floor. You will now hear loud thuds, especially on 3rd and 6th floors, due to the contractor utilizing powder actuated fasteners (power tools) to secure the framing. Central supply stocks ear plugs, if you have patients who need them.



General scraping, pounding, grinding, demolition noise on the 4th floor, 68 building and patient tower will continue.

When is this happening?

Week of Oct 18 – 22

Why is this happening?

As part of the Master Facility Plan, we are remodeling the 4th floor 68 building and 4th floor patient tower to accommodate a new Mother Baby Unit. This construction will be ongoing until summer of 2022.



Who to call with questions?

Phil Villarreal, extension 2297

Jackie Van Cleave, extension 7785

Kelly Archer, extension 6487
